|
Mull Drilling Completes Successful Horizontal Well
In Ness County
In April, Mull Drilling Co., Inc. completed the Ummel #4-H,
a horizontal drilling effort involving the combined resources
of Mull, the Kansas Geological Survey, and the Department of
Energy. The drilling contractor was Norseman Drilling, Sperry-Sun
provided the guidance and surveys, Weatherford and Scientific
Drilling the specialty tools, Dunbar Mud the drilling fluids,
and LogTech the setting tools. The well was completed in the
Warsaw (Mississippian) formation in the Ness City North Field

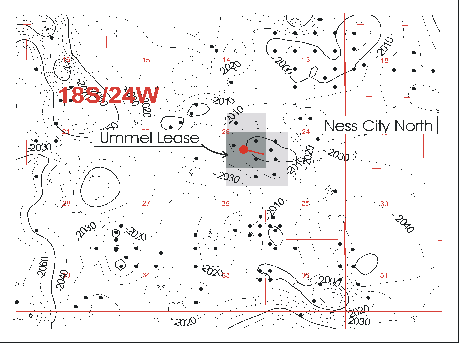

in Ness County, Kansas.
The project involved detailed reservoir characterization and
simulation, performed by KGS personnel as part of the DOE Class
2 project, to describe and evaluate the reservoir. Geologic,
pressure and production data from the vertical wells in the field
were utilized in formulating the simulation of the horizontal
well.
The old Ummel #4, a plugged and abandoned vertical well, was
reentered and the 5 ½" casing was cleaned out. The
kick-off portion of the curve began at a depth of 4115', using
a radius of approximately 180' the horizontal portion of the
lateral was at a true vertical depth of 4298'. The lateral length,
within the Mississippian, is 533 feet. A 3 ½" liner
was run to 4400', leaving the last 428' open. The well was completed
natural. A 2" rod-pump was set at 4003' in the vertical
section about 300 feet above TVD.
Mark Shreve, president and CEO of Mull, stated that Mull would
not have been able to drill the well "at this time"
without the benefit of the DOE grant. Their company, as well
as the rest of the industry in Kansas, is still basically learning
about horizontal drilling and the DOE assistance was instrumental
in providing enough additional capital to offset the expense
of developing the "learning curve". Due to problems
experienced in this well, Mull probably will drill new wells
rather than utilize the reentry method in the future. Problems
were encountered drilling cement out of the old casing, orienting
the tools to cut the casing window, handling sloughing shale
in the build section of the new hole and difficulty running the
liner. Shreve further stated that the most critical aspect of
drilling the horizontal well is drilling the curve and emphasized
the necessity of expert navigation - in this case, Sperry-Sun.
In future wells, the company will case the build section prior
to drilling the lateral. The process of drilling out the old
hole, setting the whipstock, milling the casing window, and drilling
the build section took twelve days, while only three days were
required to drill the lateral and run the liner.
Desiring to keep total fluid withdrawal within the 100-150
BPD range, the operator has limited the pumping rate. Initial
producing rate was 69 BOPD and 62 BWPD. Now, nearly two months
later, the rate is relatively stable at 48 BOPD and 48 BWPD.
Adding data obtained from the horizontal well to that which was

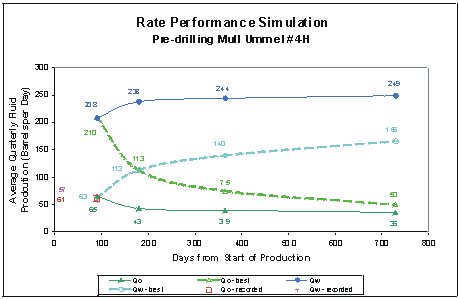

previously gained from the old wells, KGS personnel performed
a post-drilling simulation of the Ummel #4-H. The results of
this simulation indicate the well should ultimately produce 80,000
to 100,000 barrels of oil, much better than could be anticipated
from a vertical infill well drilled into the same reservoir.
A technical workshop on horizontal drilling that will be cosponsored
by North Midcontinent PTTC will be conducted in conjunction with
the annual KIOGA meeting. Additional details on the drilling
of this horizontal well will be presented at the workshop, which
will include photographs taken during the drilling process by
Richard Pancake. Richard is a petroleum engineer with TORP who
was responsible for the observation and documentation of the
drilling of this well. |
